| Project Status |
| The month of October saw the continuation of work on the block work, plaster & MEP first-fix throughout the buildings. The external stone cladding work commenced on the DEZ & MoE buildings as well as the external plaster work on the parapets and Service Block. The backfilling work continued on the underground water tank with the completion expected in November 2002. Work also continued on the external works for services and the permanent power connection from DEWA. The interior design and the FF&E tender proposals were received and are currently under review. The project progress reporting has been adjusted to reflect the final agreed weighting of the major phases of the project, namely 3% for Pre-Design, 10% for Design, 2% for Tendering and 85% for Construction. The overall project progress to date is as follows: - |
| As of October 31, 2002 |

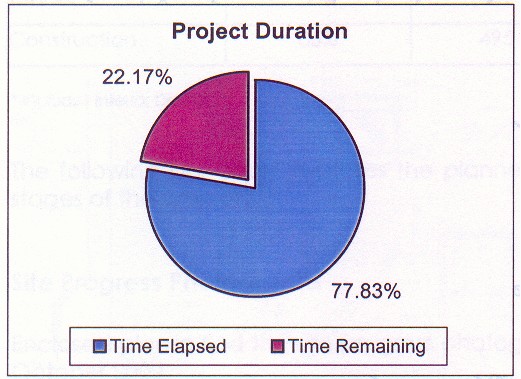

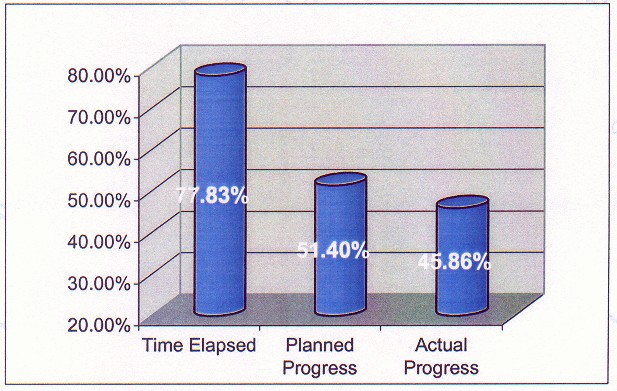

| Exp. Total Project Duration 663 days Project Start Date 2 June 2001 Exp. Project Completion Date 27 March 2003 Days Elapsed 516 days Days Remaining 147 days Time Elapsed 77.83 % Time Remaining 22.17 % Planned % Completion 51.40 % Actual % Completion 45.86 % Overall Delay 37 Days |
Ministry of Education & Dubai Education Zone Project Dubai - U.A.E. |
![]() |
![]() |
![]() |
![]() |
![]() |
