(I) How did you plan your risk?



Below figure ‘Risk management’ shows how the risk is identified and planned. It’s possible that every organization or we will say rather every project differ in the way they plan risk. We will look in to the way generally a process oriented organization will look at how risk is planned.





Risk ID

Risk Description

1001

Resignations in project

1002

Customer changes a lot.

1003

New technology

1004

Power shutdown



Table: - Risk Identification





Risk ID

Risk Description

Probability

of failure

1001

Resignations in project

3

1002

Customer changes a lot.

2

1003

New technology

1

1004

Power shutdown

2



Table: - Give probability rating









Risk ID

Risk Description

Probability

of failure

Impact

1001

Resignations in project

3

1

1002

Customer changes a lot.

2

2

1003

New technology

1

1

1004

Power shutdown

2

3



Table: - Give impact rating





Risk ID

Risk Description

Probability

of failure

Impact

Priority

1001

Resignations in project

3

1

4

1002

Customer changes a lot.

1

2

3

1003

New technology

1

1

2

1004

Power shutdown

2

3

5



Table: - Depending on probability and impact decide priority



Depending on the priority we again rearrange the risk. Below table shows the risk now arranged in a prioritized way. This gives us a logical way of dealing with the risks.



Risk ID

Risk Description

Priority

1004

Power shutdown

5

1001

Resignations in project

4

1002

Customer changes a lot.

3

1003

New technology

2



Table: - Rearranging risk according to priority









Risk ID

Risk Description

Risk Mitigating plan

1004

Power shutdown

Put backup servers on different geographical locations.

1001

Resignations in project

Should have weekly knowledge transfer plan so that project does not depend on one resource.

1002

Customer changes a lot.

Requirement documents and acceptance plan should be signed off before starting the project.

1003

New technology

Before starting the project every one in the team should go through a proper training on the new technology.

Table: - Mitigation plan for risk

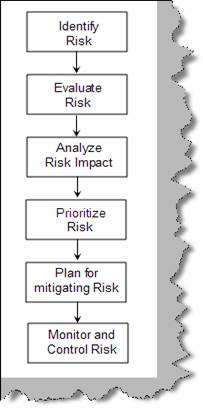

Figure: - Risk Management



Note: - One of the important points which an interviewer will like to see is how the risk was prioritized. In the above explanation we have done the same by adding probability and impact, but it can vary. For instance in many of the organization it can be done by having joint meeting with stake holders where the risk will be prioritized.
