Designer/2000ä for Project Managers
Chester R. West II

A CASE tool for Project Managers?
That’s right, Oracle[TW1]Ò has been gracious enough to provide some facilities and information within their CASE tool to even help the project manager. I have had the unique advantage of being a developer and analyst prior to doing any project management. But many of today’s project managers have not worked their way up as developers first. They then rely heavily on scheduling tools and have little idea how the development tools of the project work or if their developers work. Too many project managers today also depend heavily on their developers to tell them where they are in the project, thus making the project manager just a well paid record keeper and in turn fulfilling the CASE acronym ‘Computer Assisted Salary Enhancement’. Well, it is high time you take the step into the world of the CASE tool and I will show you how to get started. Many of the things I try to show are not only for productive reasons, but also political reasons. What I mean by this is that I will try to show you ways to use the tool to show your upper management results throughout the project life cycle. I will mention up front that I try to follow the teachings of Richard Barker’s book “Case*Method: Tasks and Deliverables”, which fit nicely with the OracleÒ CASE tool Designer/2000ä.
What
to know about CASE setup.
Designer/2000ä, as you probably already know, is the OracleÒ CASE tool for designing a complete application system. And as a project manager, you are usually the person that is assigning roles to the different people on a project. Thus, a project manager should have an idea of who has access to what within the tool. So, you and your trusted CASE administrator should work together to ensure that all personnel working on the project have the proper rights within the CASE tool itself. If you do not have a CASE administrator, assign one! And I would not make it your DBA, nothing against DBAs, but they usually have more important stuff to worry about. I recommend that this be one team member that is assigned now even though most team members may not be known until the Design and Build phases of your project. Your CASE administrator will be responsible for creating ALL applications in the system as well as managing the security rights for the system and the applications. This person may also be responsible for doing application and repository backups.
From a project manager’s viewpoint, every team member should have their own user-id with appropriate access to the application. This will facilitate some of the tracking methods I will explain later. I recommend that there be one userid that is the owner and administrator of the CASE repository and applications (i.e. CASE_OWNER). This gives you one userid/password to keep track of for all applications. The tool provides two levels of access within itself. First, the user must be granted rights to even use the tools. This is done in the repository administration tool. But it does not end there, each user must then be granted access to the different applications being worked on within the tool. This is done in the Repository Object Navigator, affectionately know as RON.
Now
that the tool is setup…
Now the fun begins, it is time to create your application. You may be wondering why to create your application now, since you are only in the Strategy stage of your project, rather than wait until Analysis. First, your company probably paid a lot of money for the tool, so you need to put it to work right away to show the upper management some early results from the tool. Second, Designer/2000ä tool set is made for full life cycle development and you cannot have a good end if you don not have a good beginning.
So, what can you do at this point? First, it is very, very important that you fill in the basic application properties. This will be where your design, development and maintenance staff can look and see just what this application is supposed to do. An example of the application property sheet can be seen

in Figure 1. This can be gotten to via the Repository Object Navigator by highlighting the application name at the top of the navigator window. You will notice that there is a place to put multi-line, very descriptive and short single-line information about the application. The multi-line text is identified by the bubble icon on the left. It has been my experience that if this information is accurate, then any new project staff should be able to read through this information and have a basic idea of what is to be accomplished. This also gives some initial scope to your project, even if scope has not been fully determined yet.

Figure 1
Lets review what I put into the some of the elements. The single line items are important in that you have one sentence in which to give concise information. For example, in the constraints property, you may want to note that complete installation of Oracle Financials is necessary for the project to go over correctly. Also, your priorities property may state that the application must be completed prior to a specified time. The authority property is where you note who gave permission to do the project. Most of us cannot just start projects without some type of corporate backing. The real comments and text should be put into the Text: areas found at the bottom of the property sheet. You may want to use the first line of the text entry to be the title or description of the information contained. For example, I decided to put the executive summary into the Summary text item. Paraphrasing the definition given by Dr. Paul Dorsey and Peter Koletzke in their book “Oracle Designer/2000 Handbook”, this is a short summary of what the project and/or application is composed of and should accomplish. Let me state now that the ideas I have mentioned are only examples. The most important thing that project managers should understand is that the tool is for documenting anything and everything in some way or fashion in one place. There is no ‘Right’ way to document only a ‘Wrong’ way, and that is not doing it.
Documenting
anything and everything.

Now lets say that you are the type of project manager that wants to document
anything and everything or possibly, you are performing some type of government
work that requires at least two pages of documentation for every dollar spent
on the project, minimum one million pages.
You could find places to key all of that into the CASE repository, but
lets now understand something else about the tool, everything that you put into
the tool takes up space in your OracleÒ database. This may or may not be what you want. Also, most project managers like to build
quality documentation for presentation to executives, customers and users. The Designer/2000ä tool only stores plain
text which is not always the prettiest way to present documentation. This, will now lead us to another place in
the Navigator window. You will notice
that there is a category for documents.
If you create an entry here, then you will be able to do one of two
things. One, create your document and
actually key the text into the Document Text property or you can simply
reference where the document is (Source Path) and what tool was used to

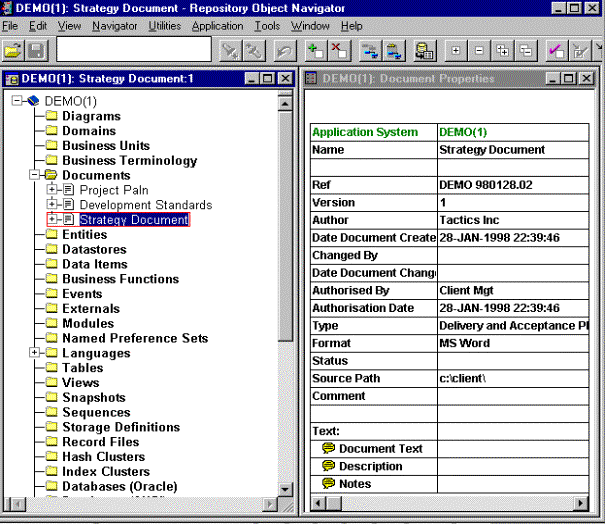

create it (Format). See Figure 2.
Figure 2
Another reason why I point out this section is because you can use the information in her to your advantage. Many of you may know that Oracle Forms, under Microsoft Windowä, supports Object Linking and Embedding (OLE) 2.0 and Dynamic Data Exchange (DDE) via the forms built-in packages OLE2 and DDE. As a matter of fact, it comes with some example forms using OLE and DDE. If you or one of your developers were to apply a little ingenuity, you could build a form to display all the documents that are defined in an application within the CASE repository. Then, based on the document you select, you could have a button that runs some OLE or DDE code to open the document. If you want to get fancy, you could actually set some standards like, what to put in the Format item of the document property. I personally have used this to identify what application was used to create the document. This allows everyone to know the appropriate word processor, spreadsheet or project management tool to use.
Other Ways to Document
Now you may want to have some of your project’s high level issues, requirements, etc. linked to something real so that you can show that you are truly being successful with the project and meeting your goals. This would require linking such things as Assumptions, Objectives, and Key Performance Indicators to such things as Modules, Functions and Business Units.

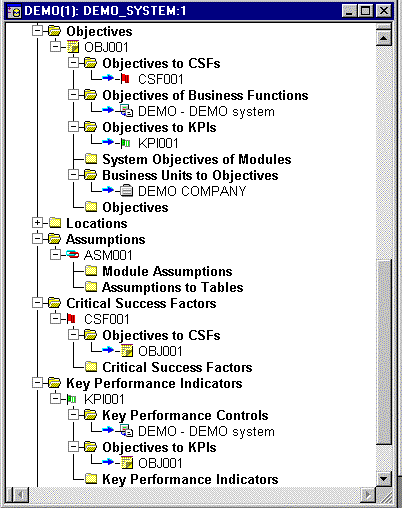

Figure 3
As you can see in figure 3, your different project items can be directly linked to other objects within the tool. For instance, lets say that you created an objective stating that the system would provide a report for use by managers for productivity measurements. Once a business function has been created to fulfill this, you can link them together. And once the module itself is created you can link them together also. You may also have objectives that are linked to business units. If you look in the property sheets of these entries, you can put date requirements, measurements and comments. This will allow you to fully document your requirements, assign responsibilities and ensure completion.
I
want to manage too!

Enough about
documenting. I think with a little bit
of looking around, you can see more places to document your application than
you can think of things to say about it.
What real project managers are interested in is, “How do I manage the
project and people on it.” Let’s break
this up a bit. Back during your
planning and scoping, you probably got a good idea of who would be on your
design, development and test teams. And
you most likely know their skill sets.
So it would be nice to be able to figure out how long it will take your
developers to complete the project. Well,
there is a way to find this out, but it requires a little work up front by
you. Look a little further down the
list on the Repository Object Navigator.
You will notice a section entitled Languages. This is not a place to indicate what
language to display (i.e. Spanish, English, etc.) If you open it up, you will see a list of programming
languages. The first thing you should
do here is define your project’s directory structure. Then, under each language that may be used in the production of
this application, document where the source and runtime directories will
be. This will help enforce some
standards and is something you can establish at the very beginning of the
project. If you expand one of the
language types you will see a section called module weighting factors. This is where you can identify some basic
time measurements for development. For
example, if you do not have any strong Oracle Reports developers on staff, you
may want to allow longer amounts of time for their development. The categories of the weighting factors are
‘EASY’, ‘AVERAGE’ and ‘DIFFICULT’ . The

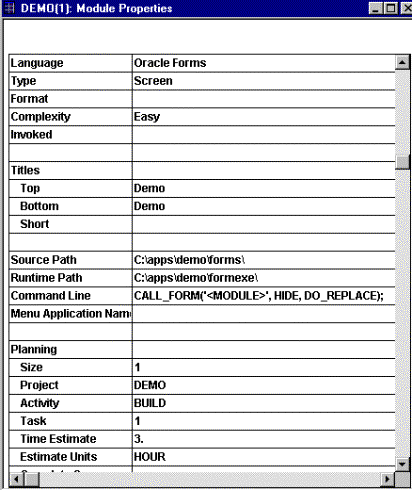

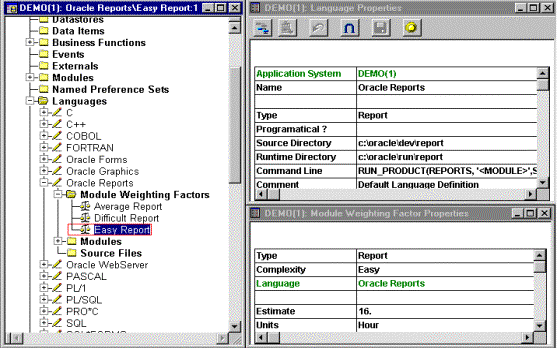

definition for weighting is as seen in Figure 4. Notice that I estimated that it would take up to 16 hours (i.e.
two working days) to complete even an easy report for my staff. Basically what I have done is accounted for
the lack of experience of the development team in building reports. But realistically, this could be seen as
more than two working days since it is very hard to get more than six actual
hours of work out of a person in an eight hour day.
Figure 4
Once your analyst have actually created modules from the Business Functions, you can then put this into use. So, know lets see just what can be done at a module level within Designer/2000ä. First, a module is an object that defines a type of coded functionality and will become your Forms, Reports, PL/SQL etc. When a new module is created, some of its properties can be filled in based on the language settings we discussed earlier. A portion of a module’s property sheet is shown in figure 5, and you can see where the language settings carried over the path and command line information as well as the time estimate information. This is not set in stone, when working with your analyst, it may be determined that a module will actually take more or less time based on post-generation coding or use of designs from similar modules. So, once one module is completed, the next one should go pretty quickly.

Figure 5
Once all your modules have been created, you can develop a simple SQL*Plus report to calculate the number of hours it will take to do each type of module as well as a totals, see table 1 for an example of the SQL that could be used. I personally have used this to show management how many man hours it may take to complete a project. Note that the SQL is coded against the repository meta-model views. A complete listing and definition of the views can be found in the on-line help.
|
SELECT SUBSTR(app.name,1,10) app, SUBSTR(lang.name,1,15) language, mod.module_type, mod.complexity, COUNT(*), SUM(wgt.estimate) hours FROM ci_modules mod, ci_application_systems app, ci_languages lang, ci_weighting_factors wgt WHERE app.name=UPPER('&application') AND mod.application_system_owned_by = app.id AND mod.completion_flag != 'Y' AND wgt.language_reference = mod.language_reference AND wgt.complexity = mod.complexity AND mod.language_reference = lang.id AND wgt.module_type = mod.module_type GROUP BY app.name, lang.name, mod.module_type, mod.complexity, wgt.id ORDER BY app.name, lang.name, mod.module_type, wgt.id |
Table 1
You may have already noticed that the planning section of the module properties also has some other places you can track your project with. First, there is the module size, now this could be a physical size estimate, or possibly a logical size as compared to the other modules. This could also be the number of function points you give the module if you do Function Point Analysis. Once again, I urge you to be creative in using the tool to your advantage. You will also want to note the project code for the module. This way, you can have your custom reports only pull information for the project you specify. And what about the activity code you say? Well, this could require a little more micro-management to get your team members to update this, or you may want to track it yourself. Here, you could identify where in the development cycle the module is (i.e. Design, Build, Testing, etc.) I have used this to link the module to a specific deliverable or task code on a project plan.
If you scroll on down on the module property sheet, you will once again see the text areas. The important ones for a project manger to track and ensure their completion are the Module Generation History and Release Notes. First, module generation will show how often the module has been created into actual Form or Report modules. I also use it to log my Post-Generation Changes. This is VERY important to the future success of maintaining the module. Anything that is done to the module after generation should be logged here so it can be duplicated if the module is changed. Second, the release notes is where you can have your developers log specific items about the module for pre-production reading by users and other developers. (i.e. ‘…this module can only be called from the Company screen and never by the Menu. This release corrects problems found in…’ )
Are
my employees working?
Now lets say your developers have told you they have been working on the modules in the CASE tool for the last few weeks, but all you have seen is lots of Solitaire games running. Unfortunately, it does happen. In the past, it has been based on their word alone if they were doing anything. Now look under the Edit menu item and select Preferences, we can attempt to resolve some of this. In the preferences dialogue box, pick the Properties tab item. Set the date format to something that includes date and time: DD/MM/YY HH24:MI:SS. Then check the ‘Show Audit Properties’ check box. See figure 6 for an example.

Figure 6
Now if you go to your different objects within the Repository Object Navigator and scroll to the bottom of the property sheet, you will see the audit information which includes creation and change dates and userids as well as a count on the number of changes as seen in figure 7. This makes it important then that each developer have their own userid rather than one common userid. And once again, you could write a custom report to print out this activity. You can also look in the Module Generation History section, if you are at that stage, to see what modules have been generated lately.

Figure 7

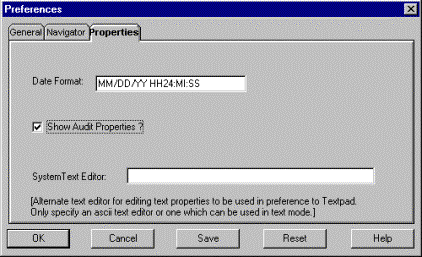

Note that in some versions of Designer/2000, the audit properties being displayed occasionally caused errors to occur within RON. The errors are not always obvious either. So it may be wise to not leave the audit properties on all the time.
Can I Log Errors and Track Problems?
Now lets say that for some strange reason, there actually were some problems either found by your developers, testers or worse the users. You would probably like to track those problems somehow. If you look back at figure 3, you will see the item problems at the bottom of the tree list. Exactly what can you track, lets look. First, I normally give some type of unique identifier to my problem codes. Then I categorize them using the TYPE property. For instance, you could log training, product availability, OracleÒ bugs and development problems. You can link them not only to a specific module, but also to business units. This could be where you would log what business units the problem is affecting. You can link it to other problems. This could be useful in tracking what problems and fixes caused other problems to occur.

You will notice in figure 8 that you can actually identify the dates of occurrence and resolution. What I like best is the ability log what opportunities of enhancement fixing the error will create. This may seem a bit corny at first, but what it does is make the problem into a positive thing when it is fixed. This will also help get the boss off your back because he will think it was a good thing that it happened. Also be aware that it is not obvious from the navigator. You may also want to create a custom report to list unresolved problems since there is no such functionality available. And it has been my experience that this can cause it to be very hard to ensure that all problems are corrected if you have a very long log.

Figure 8
Built-in
Reports.
The Designer/2000ä tool also comes with a set many reports for your use. Most of these reports will be primarily for developers but will also make good attachments for some of your delivered documents. Some of the commonly used reports by developers are the definition reports for things such as entities, functions, domains, modules and tables. There are also several reports that appeal more to project managers since they print out documentation items and even function point analysis. The most important thing to know about these reports is that the original source code is provided so you can copy them for new reports or update them directly to meet your needs (especially if you would like more information or a different layout).
Check-Out
& Check-In.
Large projects are sometimes too large for one team to work on and still meet time requirements. So, you may decide to farm out some of the work to other parts of the company or possibly even contract it out. If these other organizations cannot work onsite, then it may be more feasible to allow them to use what is called check-out. This allows you to identify a subset of the application that can be worked on at another site, in another repository. For example, remember earlier I discussed having developers that were weak on their Oracle Reports experience. And lets say you showed your time estimates to the upper management and they decide to contract experienced reports people to cut down on the time required. So, if your table definitions are completed, you can highlight the modules the contractors will be working on and under the File menu select Check-Out. This will create a CASE Loader data file in which they can load into their repository to work on the modules. When completed they can check the working copies back out of their repository and deliver the new CASE Loader data file with the generated reports. This way you can have an updated repository along with the completed reports. The other thing you will notice, is that objects that are checked out cannot be modified until they are checked back in or unlocked. This is a VERY primitive method of control, but it can work.
Conclusion.
If I have not stressed it enough already, a project manager should not be scared of this particular development tool. If anything, they should want to jump right in and learn how they too can use it. Remember that Oracle’s CASE tool is not just for data modeling and application generation, but also documentation. And if you ensure that documentation is completed where necessary, then the tool fulfills its Rapid Application Development role to it’s maximum potential. Once you have mastered the basics of extending the tool via custom reports, API utilities, etc. you will begin to come up with new and exciting ways in which to expand the tool to meet your needs completely. A word of caution though, while you can never have too much documentation about your application, there may not be enough resources to document everything that Designer/2000 allows.
Appendix
A. – A Look into the future.
(Designer/2000 2.0)
